title: Estimate Sprint Workload Accurately | Catapult Labs
description: Struggling with sprint overcommitment? Learn how to estimate sprint workload accurately and use Scrum Poker to surface your team's true capacity.
image: https://www.catapultlabs.com/hubfs/sprint-backlog-vs-scrum-poker-capacity-estimation.png
---

[![logo](https://www.catapultlabs.com/hubfs/Site/Clients/Colors=True%2c%20Format=Horizontal.svg)](https://www.catapultlabs.com) Menu

- ###### Products ![](https://www.catapultlabs.com/hubfs/Site/Navbar/Vector%20(Stroke).svg)

   Team productivity![](https://www.catapultlabs.com/hubfs/Site/Navbar/arrow-right-2.svg)
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Retros-2.svg)Agile Retros](https://www.catapultlabs.com/retrospectives)
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Scrumpoker.svg)Scrum Poker](https://marketplace.atlassian.com/apps/1218960/scrumpoker-estimates-for-jira?hosting=cloud&tab=overview)
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/TeamPulse-1.svg)TeamPulse](https://marketplace.atlassian.com/apps/1227873/teampulse-health-check-ins-for-jira?tab=overview&hosting=cloud)
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/bot-1.svg)StandBot](https://marketplace.atlassian.com/apps/1217825/standbot-slack-stand-up-bot-for-jira?hosting=server&tab=overview)
   Customer support![](https://www.catapultlabs.com/hubfs/Site/Navbar/arrow-right-2.svg)
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Sync-Jan-24-2023-05-14-14-9110-PM.svg)Freshdesk + Trello](https://www.freshworks.com/apps/freshdesk/trello)
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Sync-Jan-24-2023-05-09-14-4164-PM.svg)Freshservice + Trello](https://www.freshworks.com/apps/freshservice/trello)
- ###### Solutions New![](https://www.catapultlabs.com/hubfs/Site/Navbar/Vector%20(Stroke).svg)

   Team productivity![](https://www.catapultlabs.com/hubfs/Site/Navbar/arrow-right-2.svg)
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/devex-icon.svg)DevEx New](https://www.catapultlabs.com/solutions/devex)
- ###### Platforms![](https://www.catapultlabs.com/hubfs/Site/Navbar/Vector%20(Stroke).svg)

  ![](https://www.catapultlabs.com/hubfs/Site/Navbar/atlassian%20logo.svg)Atlassian
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Retros-2.svg)Agile Retros](https://www.catapultlabs.com/agile-retrospectives-for-jira-and-confluence)
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Scrumpoker.svg)Scrum Poker](https://marketplace.atlassian.com/apps/1218960/scrumpoker-estimates-for-jira?hosting=cloud&tab=overview)
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/TeamPulse-1.svg)TeamPulse](https://marketplace.atlassian.com/apps/1227873/teampulse-health-check-ins-for-jira?tab=overview&hosting=cloud)
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/bot-1.svg)StandBot](https://marketplace.atlassian.com/apps/1217825/standbot-slack-stand-up-bot-for-jira?hosting=server&tab=overview)
  ![](https://www.catapultlabs.com/hubfs/Site/Navbar/Trello.svg)Trello
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Retros-1.svg)Agile Retros](https://trello.com/power-ups/61f7eba5e29fd13c6884a214/agile-retrospectives)
  ![](https://www.catapultlabs.com/hubfs/Site/Navbar/Monday.svg)monday.com
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Retros-2.svg)Agile Retros](https://monday.com/marketplace/124)
  ![](https://www.catapultlabs.com/hubfs/Site/Navbar/Slack.svg)Slack
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/bot-1.svg)StandBot](https://marketplace.atlassian.com/apps/1217825/standbot-slack-stand-up-bot-for-jira?hosting=server&tab=overview)
  ![](https://www.catapultlabs.com/hubfs/Site/Navbar/Freshworks.svg)Freshworks
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Sync-2.svg)Freshdesk + Trello](https://www.freshworks.com/apps/freshdesk/trello)
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Sync-3.svg)Freshservice + Trello](https://www.freshworks.com/apps/freshservice/trello)
- ###### Resources![](https://www.catapultlabs.com/hubfs/Site/Navbar/Vector%20(Stroke).svg)

    - [![](https://www.catapultlabs.com/hs-fs/hubfs/Site/Navbar/Book.png?width=24&height=24&name=Book.png)Help center](https://help.catapultlabs.com/)
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Opened-Book.svg)Blog](https://www.catapultlabs.com/blog)
    - [![](https://www.catapultlabs.com/hubfs/Site/Navbar/devex-icon.svg)Jira DevEx Guide](https://www.catapultlabs.com/guide/developer-experience-jira)
    - [![](https://www.catapultlabs.com/hs-fs/hubfs/Site/Navbar/phone-calling.webp?width=24&height=24&name=phone-calling.webp)Contact Us](https://www.catapultlabs.com/contact)
- [Atlassian Marketplace](https://marketplace.atlassian.com/vendors/1213059/catapult-labs-llc)
- ![](https://www.catapultlabs.com/hs-fs/hubfs/Site/Navbar/Menu-Mobile.png?width=622&height=312&name=Menu-Mobile.png)

  StandBot for Slack

   Stop worrying about your stand-up logistics!

  [Get it here](https://marketplace.atlassian.com/apps/1217825/standbot-slack-stand-up-bot-for-jira?hosting=server&tab=overview)

[Atlassian Marketplace](https://marketplace.atlassian.com/vendors/1213059/catapult-labs-llc)

 Team productivity![](https://www.catapultlabs.com/hubfs/Site/Navbar/arrow-right-Apr-12-2023-05-19-56-2589-AM.svg)

 Customer support![](https://www.catapultlabs.com/hubfs/Site/Navbar/arrow-right-Apr-12-2023-05-19-56-2589-AM.svg)

[![](https://www.catapultlabs.com/hubfs/Site/Navbar/Retros-3.svg) Agile Retros Run engaging retrospectives inside Jira, Confluence, monday.com & Trello](https://www.catapultlabs.com/retrospectives) [![](https://www.catapultlabs.com/hubfs/Site/Navbar/TeamPulse-1.svg) TeamPulse Build trust among your team by running health check-ins in Jira](https://marketplace.atlassian.com/apps/1227873/teampulse-health-check-ins-for-jira?tab=overview&hosting=cloud) [![](https://www.catapultlabs.com/hubfs/Site/Navbar/bot-1.svg) StandBot Keep your team in sync with asynchronous stand-ups in Slack](https://marketplace.atlassian.com/apps/1217825/standbot-slack-stand-up-bot-for-jira?hosting=server&tab=overview) [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Scrumpoker.svg) Scrum Poker Estimate development tasks playing Planning Poker in Jira or Confluence](https://marketplace.atlassian.com/apps/1218960/scrumpoker-estimates-for-jira?hosting=cloud&tab=overview)

[![](https://www.catapultlabs.com/hubfs/Site/Navbar/Sync-Jan-24-2023-05-14-14-9110-PM.svg) Freshdesk + Trello Keep your support teams in sync by linking Freshdesk tickets to Trello cards](https://www.freshworks.com/apps/freshdesk/trello) [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Sync-Jan-24-2023-05-09-14-4164-PM.svg) Freshservice + Trello Empower your IT teams to collaborate by linking Freshservice tickets to Trello cards](https://www.freshworks.com/apps/freshservice/trello)

![](https://www.catapultlabs.com/hs-fs/hubfs/Site/Navbar/robot%20logo.png?width=481&height=271&name=robot%20logo.png)

StandBot for Slack

 Stop worrying about your stand-up logistics!

[Get it here![](https://www.catapultlabs.com/hubfs/Site/Navbar/arrow-right-Apr-12-2023-05-19-56-2589-AM.svg)](https://marketplace.atlassian.com/apps/1217825/standbot-slack-stand-up-bot-for-jira?hosting=server&tab=overview)

![](https://www.catapultlabs.com/hubfs/Site/Navbar/atlassian%20logo.svg)Atlassian

[![](https://www.catapultlabs.com/hubfs/Site/Navbar/Retros-3.svg) Agile Retros Run engaging retrospective sessions inside Jira or Confluence](https://www.catapultlabs.com/agile-retrospectives-for-jira-and-confluence) [![](https://www.catapultlabs.com/hubfs/Site/Navbar/TeamPulse-1.svg) TeamPulse Build trust among your team by running health check-ins in Jira](https://marketplace.atlassian.com/apps/1227873/teampulse-health-check-ins-for-jira?tab=overview&hosting=cloud) [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Scrumpoker.svg) Scrum Poker Estimate development tasks playing Planning Poker in Jira or Confluence](https://marketplace.atlassian.com/apps/1218960/scrumpoker-estimates-for-jira?hosting=cloud&tab=overview) [![](https://www.catapultlabs.com/hubfs/Site/Navbar/bot-1.svg) StandBot Keep your team in sync with asynchronous stand-ups in Slack](https://marketplace.atlassian.com/apps/1217825/standbot-slack-stand-up-bot-for-jira?hosting=server&tab=overview)

StandBot for Slack

 Stop worrying about your stand-up logistics!

- ![](https://www.catapultlabs.com/hs-fs/hubfs/Site/Standbot%20LP/checkmark-1.png?width=24&height=24&name=checkmark-1.png)Products Updates
- ![](https://www.catapultlabs.com/hs-fs/hubfs/Site/Standbot%20LP/checkmark-1.png?width=24&height=24&name=checkmark-1.png)Get immediate notifications on blockers
- ![](https://www.catapultlabs.com/hs-fs/hubfs/Site/Standbot%20LP/checkmark-1.png?width=24&height=24&name=checkmark-1.png)Export your stand-up data as CSV

[Get it here![](https://www.catapultlabs.com/hubfs/Site/Navbar/arrow-right-Apr-12-2023-05-19-56-2589-AM.svg)](https://marketplace.atlassian.com/apps/1217825/standbot-slack-stand-up-bot-for-jira?hosting=server&tab=overview)

![](https://www.catapultlabs.com/hs-fs/hubfs/Site/Navbar/robot%20logo.png?width=481&height=271&name=robot%20logo.png)

![](https://www.catapultlabs.com/hubfs/Site/Navbar/Trello.svg)Trello

[![](https://www.catapultlabs.com/hubfs/Site/Navbar/Sync-Jan-24-2023-05-09-14-4164-PM.svg) Agile Retros Run engaging retrospective sessions inside Trello](https://trello.com/power-ups/61f7eba5e29fd13c6884a214/agile-retrospectives)

![](https://www.catapultlabs.com/hubfs/Site/Navbar/Monday.svg)

monday.com

[![](https://www.catapultlabs.com/hubfs/Site/Navbar/Retros-3.svg) Agile Retros Run engaging retrospective sessions inside Jira or Confluence](https://monday.com/marketplace/124)

![](https://www.catapultlabs.com/hubfs/Site/Navbar/Slack.svg)

Slack

[![](https://www.catapultlabs.com/hubfs/Site/Navbar/bot-1.svg) StandBot Keep your team in sync with asynchronous stand-ups in Slack](https://marketplace.atlassian.com/apps/1217825/standbot-slack-stand-up-bot-for-jira?hosting=server&tab=overview)

![](https://www.catapultlabs.com/hubfs/Site/Navbar/Freshworks.svg)Freshworks

[![](https://www.catapultlabs.com/hubfs/Site/Navbar/Sync-Jan-24-2023-05-14-14-9110-PM.svg) Freshdesk + Trello Tips & tricks on everything Agile related, remote teams, and all their possibilities](https://www.freshworks.com/apps/freshdesk/trello) [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Sync-Jan-24-2023-05-09-14-4164-PM.svg) Freshservice + Trello Empower your IT teams to collaborate by linking Freshservice tickets to Trello cards](https://www.freshworks.com/apps/freshservice/trello)

[![](https://www.catapultlabs.com/hs-fs/hubfs/Site/Navbar/Book.png?width=24&height=24&name=Book.png) Help center Learn how to install, set up, and use our different products](https://help.catapultlabs.com/) [![](https://www.catapultlabs.com/hubfs/Site/Navbar/Opened-Book.svg) Blog Tips & tricks on everything Agile related, remote teams, and all their possibilities](https://www.catapultlabs.com/blog) [![](https://www.catapultlabs.com/hubfs/Site/Navbar/devex-icon.svg) Jira DevEx Guide The ultimate DevEx guide for Agile teams](https://www.catapultlabs.com/guide/developer-experience-jira) [![](https://www.catapultlabs.com/hs-fs/hubfs/Site/Navbar/phone-calling.webp?width=24&height=24&name=phone-calling.webp) Contact Us](https://www.catapultlabs.com/contact)

 Team productivity![](https://www.catapultlabs.com/hubfs/Site/Navbar/arrow-right-Apr-12-2023-05-19-56-2589-AM.svg)

[![](https://www.catapultlabs.com/hubfs/Site/Navbar/devex-icon.svg) DevEx New A suite of apps designed to revive scattered, disengaged Agile rituals](https://www.catapultlabs.com/solutions/devex)

[![](https://www.catapultlabs.com/hubfs/Site/arrow-left.svg) Return to Blog](https://www.catapultlabs.com/blog)

 Sprint Planning

# How to Estimate Sprint Workload Accurately (Without Over- or Under-Committing Your Team)

 10 min read  1 October, 2026

![Luis Ortiz](https://www.catapultlabs.com/hubfs/Luis%20Ortiz%20headshot.png)

[Luis Ortiz](https://www.catapultlabs.com/blog/author/luis-ortiz)

Table of Content

[Sprint Planning](https://www.catapultlabs.com/blog/tag/sprint-planning) [Scrum Poker](https://www.catapultlabs.com/blog/tag/scrum-poker) [Agile Estimation](https://www.catapultlabs.com/blog/tag/agile-estimation) [Scrum Masters](https://www.catapultlabs.com/blog/tag/scrum-masters) [Capacity Planning](https://www.catapultlabs.com/blog/tag/capacity-planning) [Sprint Commitment](https://www.catapultlabs.com/blog/tag/sprint-commitment) [Story Points](https://www.catapultlabs.com/blog/tag/story-points) [Team Capacity](https://www.catapultlabs.com/blog/tag/team-capacity)

Share this

[![Share on linkedin](https://www.catapultlabs.com/hubfs/Site/Blogs/linkedin-default.svg)](http://www.linkedin.com/shareArticle?mini=true&url=https%3A%2F%2Fwww.catapultlabs.com%2Fblog%2Festimate-sprint-workload-accurately%3Futm_medium%3Dsocial%26utm_source%3Dlinkedin)

[![Share on twitter](https://www.catapultlabs.com/hubfs/Site/Blogs/twitter-default.svg)](https://twitter.com/intent/tweet?original_referer=https%3A%2F%2Fwww.catapultlabs.com%2Fblog%2Festimate-sprint-workload-accurately%3Futm_medium%3Dsocial%26utm_source%3Dtwitter&url=https%3A%2F%2Fwww.catapultlabs.com%2Fblog%2Festimate-sprint-workload-accurately%3Futm_medium%3Dsocial%26utm_source%3Dtwitter&source=tweetbutton&text=)

[![Share on facebook](https://www.catapultlabs.com/hubfs/Site/Blogs/facebook-default.svg)](http://www.facebook.com/share.php?u=https%3A%2F%2Fwww.catapultlabs.com%2Fblog%2Festimate-sprint-workload-accurately%3Futm_medium%3Dsocial%26utm_source%3Dfacebook)

[![Share on youtube](https://www.catapultlabs.com/hubfs/Site/Blogs/youtube-default.svg)](http://www.linkedin.com/shareArticle?mini=true&url=https%3A%2F%2Fwww.catapultlabs.com%2Fblog%2Festimate-sprint-workload-accurately%3Futm_medium%3Dsocial%26utm_source%3Dyoutube)

### Join our newsletter

 The best collaborative work insights.

![Newsletter](https://www.encora.com/hubfs/Catapult-Labs-site/Newsletter.png)

[Sprint Planning](https://www.catapultlabs.com/blog/tag/sprint-planning) [Scrum Poker](https://www.catapultlabs.com/blog/tag/scrum-poker) [Agile Estimation](https://www.catapultlabs.com/blog/tag/agile-estimation) [Scrum Masters](https://www.catapultlabs.com/blog/tag/scrum-masters) [Capacity Planning](https://www.catapultlabs.com/blog/tag/capacity-planning) [Sprint Commitment](https://www.catapultlabs.com/blog/tag/sprint-commitment) [Story Points](https://www.catapultlabs.com/blog/tag/story-points) [Team Capacity](https://www.catapultlabs.com/blog/tag/team-capacity)

⚡ Quick Answer

How do you estimate sprint workload accurately?

Estimate each story with points, then check the total against your team's actual historical capacity, not a target number that simply feels ambitious. Most overcommitment happens because teams size stories correctly but skip that second step: comparing the sum to what they've genuinely finished in past sprints.

- Story estimates size the work. Sprint capacity tells you how much of that work your team can absorb.
- Base capacity on what the team finished (not started) in its last four to six sprints, adjusted for PTO, holidays, and on-call.
- Leave a buffer for unplanned work, and cut scope in planning when the total exceeds capacity.

Every Scrum Master has sat through the same postmortem: the team pointed every story carefully, the planning poker session went fine, and the sprint still blew up. Half the backlog rolled over, again. If you want to estimate sprint workload accurately, the fix usually isn't a better estimation technique. It's a step most teams skip entirely: checking the sum of those estimates against what the team can actually deliver.

## **Why Sprint Estimates Go Wrong Even When Your Story Points Are Right**

Story points get the blame for almost every blown sprint, but in most cases the individual estimates are fine. A team sizes ten stories, argues through the disagreements, lands on numbers everyone can defend, and still ends the sprint with four stories in review and two that never got picked up.

That gap doesn't come from poor story point estimation accuracy. It comes from what happens right after sizing: the team adds up the points, the total looks reasonable on a whiteboard, and everyone nods it through without asking the one question that predicts whether the sprint will land. Has this team ever finished this much work in one sprint before?

Skip that question and you're not estimating a sprint. You're hoping for one.

## **Estimating a Story vs. Estimating a Sprint: Why They're Different Skills**

These get treated as the same exercise, and that's the root of most sprint overcommitment. They're not.

Estimating a story is a sizing judgment: how big is this one piece of work relative to others the team has done? Estimating a sprint is a capacity judgment, and it's the heart of sprint capacity planning: given everything else going on (on-call rotations, a teammate's PTO, the meetings already on the calendar), how much of that sized work can this specific team absorb in the next two weeks?

**Sprint capacity** is the amount of work a team can realistically complete in one sprint, based on its own historical throughput and available hours, not a number set by leadership or one that simply sounds ambitious. It's distinct from a story estimate, which sizes a single piece of work; capacity is what tells a team when to stop pulling in more of those correctly-sized stories.

If your team is still deciding which technique to use for sizing individual stories (planning poker versus t-shirt sizes versus the bucket system), that's a separate decision, and we've covered it in [choosing the right estimation technique for your team](https://www.catapultlabs.com/blog/tips-for-more-accurate-estimating-sessions). This post picks up after that decision is made: once your stories are sized, how do you know how many of them your team can realistically commit to?

## **How to Estimate Sprint Workload Accurately, Step by Step**

The method itself isn't complicated. Most teams never formalize it.

**1. Total the story points for everything you're about to pull into the sprint.** This is the part every team already does.

**2. Calculate your team's real historical capacity, not its average velocity.** Look back at your last four to six sprints and note what got *finished*, not what got started. That number, not a target someone set, is your team capacity for sprint planning. Then adjust for anything that made those sprints unusual: a sprint where two people were out doesn't represent your normal capacity, and neither does the one sprint where everything happened to go right. It's the same data-driven forecasting Atlassian recommends for sprint planning: plan from historical performance, not from how ambitious the sprint feels.

**3. Compare the total against that capacity number, not against how the sprint "feels."** A backlog that looks reasonable to scroll through is not the same as a backlog your team has evidence it can finish. If the total exceeds capacity, that's the signal to cut scope now, not the signal to hope the team moves faster this time.

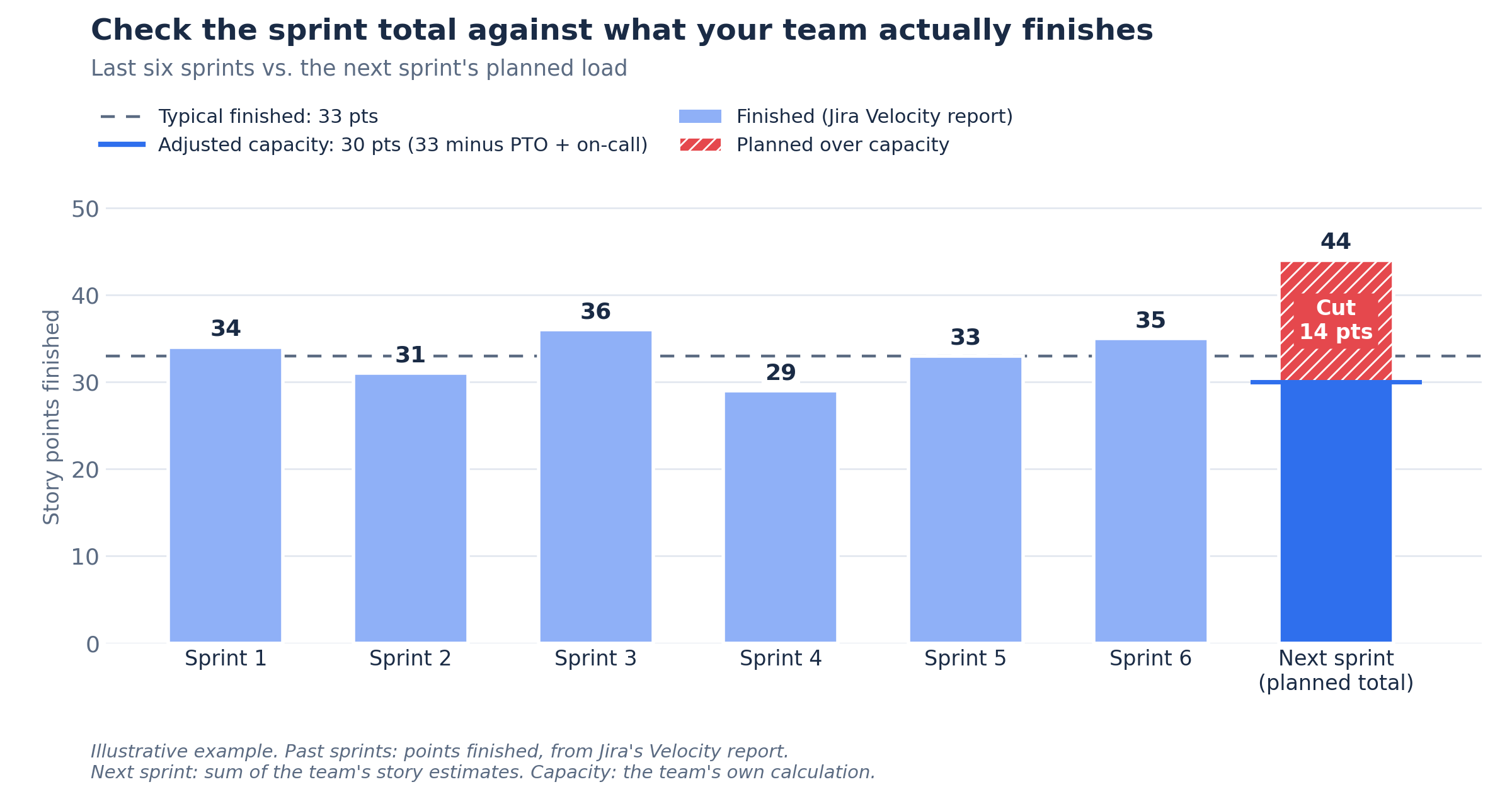

![Bar chart comparing a team's finished story points over six sprints, from Jira's Velocity report, with a next sprint planned at 44 points, 14 points above its adjusted capacity of 30, showing where to cut scope](https://www.catapultlabs.com/hs-fs/hubfs/sprint-capacity-check-planned-vs-historical.png?width=2400&height=1260&name=sprint-capacity-check-planned-vs-historical.png)

**4. Adjust for what's different about this specific sprint.** A public holiday, a teammate's onboarding ramp, an on-call rotation landing on your team: each of these reduces real capacity below your historical average, and none of them show up in a story point total.

**5. Leave a buffer for the work that isn't on the board yet.** Production issues, code review backlog, and the small requests that arrive mid-sprint are predictable in aggregate even when they're unpredictable individually. Teams that estimate sprint workload accurately plan for that buffer instead of discovering it the hard way in week two.

## **Using Scrum Poker to Surface Your Team's Real Capacity Before You Commit**

Step 1 above only works if the estimates going into it are honest, and that's harder than it sounds in a room where the loudest engineer's number quietly becomes everyone's number. [Running a structured Scrum Poker estimation session in Jira](https://marketplace.atlassian.com/apps/1218960/scrumpoker-estimates-for-jira?hosting=cloud&tab=overview&utm_source=catapult-blog&utm_medium=referral&utm_campaign=2026-q3-how-to-estimate-sprint-workload&utm_content=h2-intl-link-teams-real-capacity) fixes that at the source: every team member submits their estimate privately, at the same time, so the number on the table reflects what the team thinks, not what the first person said. That means the total you're checking against capacity in Step 3 is a real number, not an anchored guess.

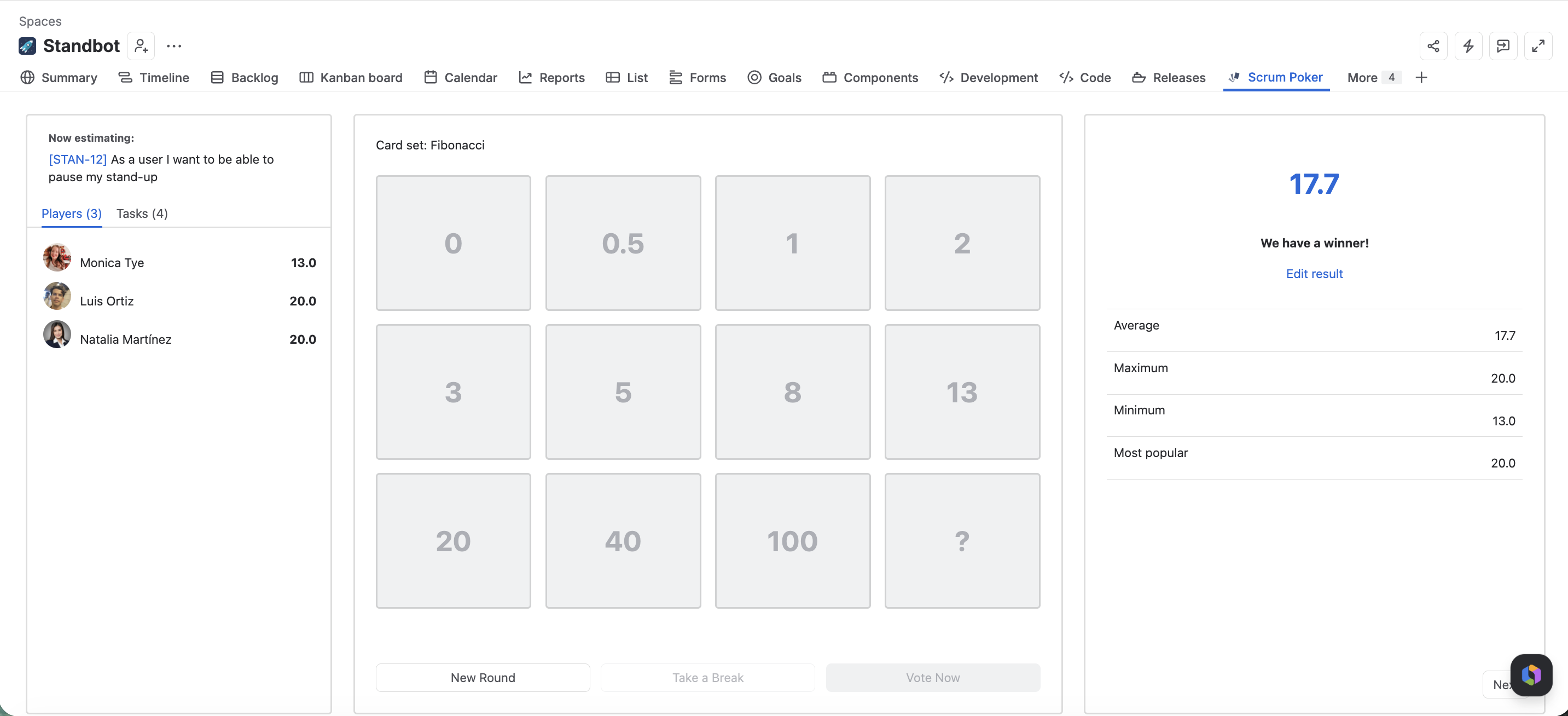

![Scrum Poker for Jira session showing three team members' estimates revealed at once, 13, 20 and 20 points, with an average of 17.7 on a Jira story](https://www.catapultlabs.com/hs-fs/hubfs/scrum-poker-jira-revealed-votes-estimate-spread.png?width=2866&height=1308&name=scrum-poker-jira-revealed-votes-estimate-spread.png)

It also makes Step 2 easier. Scrum Poker keeps a sprint planning archive and sends final estimates back to the Jira issues they sized, which means the "last four to six sprints" comparison isn't a spreadsheet someone has to rebuild from memory. It's already sitting in your sprint planning history, ready to pull up the next time you're deciding how much to commit to.

**Try Scrum Poker Free on Jira →** [Install Scrum Poker free on Jira](https://marketplace.atlassian.com/apps/1218960/scrumpoker-estimates-for-jira?hosting=cloud&tab=overview&utm_source=catapult-blog&utm_medium=referral&utm_campaign=2026-q3-how-to-estimate-sprint-workload&utm_content=mid-cta) and run your next planning session with private voting from the start.

**Also Planning in Confluence? →** [Get Scrum Poker for Confluence](https://marketplace.atlassian.com/apps/1215875/scrumpoker-estimates-for-confluence?utm_source=catapult-blog&utm_medium=referral&utm_campaign=2026-q3-how-to-estimate-sprint-workload&utm_content=mid-cta)

Capacity problems and burnout problems tend to travel together: a team that's chronically over-committed is usually a team that's chronically tired, whether or not anyone's said so out loud yet. If you want to avoid sprint burnout before it shows up in your retros, [pair capacity planning with team health checks in the DevEx suite](https://www.catapultlabs.com/solutions/devex), where Scrum Poker and TeamPulse work side by side.

## **Overcommitment Traps That Slip Past Even Experienced Scrum Masters**

A few patterns show up again and again, even on teams that are otherwise disciplined about estimating:

**Anchoring to your best sprint instead of your typical one.** The sprint where everything clicked and the team finished 20% more than usual becomes the mental benchmark for every sprint after it, instead of the outlier it was.

**Treating on-call as free time.** Whoever's on call that sprint gets pulled into interrupts that never make it onto the board, but their story point allocation stays the same as everyone else's.

**"Stretch" scope that becomes committed scope.** A stretch goal added with good intentions gets treated as a promise the moment it's said out loud in planning, even though nobody agreed the team had capacity for it.

**Ignoring the cost of context switching.** A sprint with five small unrelated stories takes more out of a team than a sprint with two large related ones, even at the same total point count, because every switch between unrelated work has a real setup cost that story points don't capture.

Atlassian's guidance on running planning meetings covers several of these patterns from the facilitation side. See their [best practices for sprint planning meetings](https://www.atlassian.com/blog/development/sprint-planning-atlassian) for the meeting-structure half of this problem. And if you want the mechanics of how Jira calculates and displays estimates once they're in, their documentation on [estimating a work item](https://support.atlassian.com/jira-software-cloud/docs/estimate-an-issue/) is worth a skim before your next planning session.

## **Commit to What Your Team Can Actually Finish**

None of this is about estimating more precisely. Precision was never the problem. Most teams already size stories carefully. The problem is committing to a total nobody checked against evidence of what the team can deliver.

Estimate the work. Then estimate the team, honestly, against its own history rather than its best day. Do both, and the sprint you commit to in planning is the sprint you actually finish.

## **Frequently Asked Questions**

Why do sprint estimates go wrong even when story points are right?

Because the failure point is usually the commitment, not the sizing. Teams estimate each story carefully, add up the points, and accept a total that looks reasonable without checking it against what they have finished in past sprints. Every individual estimate can be correct while the sprint total is still more work than the team has ever delivered in a single sprint.

What is the difference between estimating a story and estimating a sprint?

Estimating a story is a sizing judgment: how big one piece of work is relative to others the team has done. Estimating a sprint is a capacity judgment: how much of that sized work this specific team can absorb in the next sprint, given on-call rotations, PTO, and meetings. Sprint capacity comes from the team's own historical throughput and available hours, not a number set by leadership.

How do you estimate sprint workload accurately?

Total the story points for everything you plan to pull in, then compare that total against your team's real historical capacity from the last four to six sprints, counting only finished work. Adjust for what is different this sprint, such as holidays, onboarding, or on-call load, and leave a buffer for unplanned work. If the total exceeds capacity, cut scope before the sprint starts.

How does Scrum Poker help a team estimate sprint capacity?

Scrum Poker for Jira has every team member vote privately and at the same time, so estimates reflect what the whole team thinks instead of anchoring to the first or loudest voice. That makes the sprint total you compare against capacity more honest. It also keeps a sprint planning archive and sends final estimates back to Jira issues, so past sessions are easy to review at the next planning.

How do you stop your team from overcommitting every sprint?

Watch for four common traps: anchoring to your best sprint instead of your typical one, treating on-call time as free capacity, letting stretch goals quietly become committed scope, and ignoring the cost of context switching between unrelated stories. Plan against typical historical capacity, reduce the allocation for whoever is on call, keep stretch work explicitly optional, and group related stories where you can.



Give your next planning session honest estimates and a real capacity check from day one.

[Try Scrum Poker Free on Jira](https://marketplace.atlassian.com/apps/1218960/scrumpoker-estimates-for-jira?utm_source=catapult-blog&utm_medium=referral&utm_campaign=2026-q3-how-to-estimate-sprint-workload&utm_content=cta-button)

![Luis Ortiz](https://www.catapultlabs.com/hubfs/Luis%20Ortiz%20headshot.png)

 Luis Ortiz

 Luis is the Co-Founder and leads Growth at Catapult Labs. He writes about practical Agile workflows across Jira, Confluence, and Slack, helping teams run better stand-ups, retrospectives, and improve productivity without meeting overload.

[![](https://www.catapultlabs.com/hubfs/Site/Footer/linkedin.png)](https://www.linkedin.com/in/luis-ortiz-23a4a482/)

#### You might also like

[![logo](https://www.catapultlabs.com/hs-fs/hubfs/Site/Footer/Colors=True%2c%20Format=Horizontal%20(1).png?width=200&height=48&name=Colors=True%2c%20Format=Horizontal%20(1).png)](https://www.catapultlabs.com)

[![balloon-1](https://www.catapultlabs.com/hubfs/Site/Footer/balloon-1.svg)](https://www.catapultlabs.com/contact)

Products

[Agile Retros](https://marketplace.atlassian.com/apps/1218860/agile-retrospectives-for-jira?hosting=datacenter&tab=overview)

[Scrum Poker](https://marketplace.atlassian.com/apps/1218960/scrumpoker-estimates-for-jira?hosting=cloud&tab=overview)

[TeamPulse](https://marketplace.atlassian.com/apps/1227873/teampulse-health-check-ins-for-jira?tab=overview&hosting=cloud)

[StandBot](https://marketplace.atlassian.com/apps/1217825/standbot-slack-stand-up-bot-for-jira?hosting=server&tab=overview)

[Freshdesk + Trello](https://www.freshworks.com/apps/freshdesk/trello)

[Freshservice + Trello](https://www.freshworks.com/apps/freshservice/trello)

[Blog](https://www.catapultlabs.com/blog)

[Help center](https://help.catapultlabs.com/)

[![twitter](https://www.catapultlabs.com/hs-fs/hubfs/Site/Footer/twitter.png?width=24&height=24&name=twitter.png)](https://twitter.com/CatapultLabs_) [![linkedin](https://www.catapultlabs.com/hs-fs/hubfs/Site/Footer/linkedin.png?width=24&height=24&name=linkedin.png)](https://www.linkedin.com/company/25009688/) [![youtube](https://www.catapultlabs.com/hubfs/Site/Footer/YouTube_full-color_icon.svg)](https://www.youtube.com/@catapultlabs)

Products

 Atlassian

[Agile Retros](https://marketplace.atlassian.com/apps/1218860/agile-retrospectives-for-jira?hosting=datacenter&tab=overview)

[Scrum Poker](https://marketplace.atlassian.com/apps/1218960/scrumpoker-estimates-for-jira?hosting=cloud&tab=overview)

[TeamPulse](https://marketplace.atlassian.com/apps/1227873/teampulse-health-check-ins-for-jira?tab=overview&hosting=cloud)

[StandBot](https://marketplace.atlassian.com/apps/1217825/standbot-slack-stand-up-bot-for-jira?hosting=server&tab=overview)

 Trello

[Agile Retros](https://trello.com/power-ups/61f7eba5e29fd13c6884a214/agile-retrospectives)

 Monday

[Agile Retros](https://monday.com/marketplace/124)

Slack

[StandBot](https://marketplace.atlassian.com/apps/1217825/standbot-slack-stand-up-bot-for-jira?hosting=server&tab=overview)

 Freshworks

[Freshdesk + Trello](https://www.freshworks.com/apps/freshdesk/trello)

[Freshservice + Trello](https://www.freshworks.com/apps/freshservice/trello)

[Blog](https://www.catapultlabs.com/blog)

[Help center](https://help.catapultlabs.com/)

[![twitter](https://www.catapultlabs.com/hs-fs/hubfs/Site/Footer/twitter.png?width=24&height=24&name=twitter.png)](https://twitter.com/CatapultLabs_) [![linkedin](https://www.catapultlabs.com/hs-fs/hubfs/Site/Footer/linkedin.png?width=24&height=24&name=linkedin.png)](https://www.linkedin.com/company/25009688/) [![youtube](https://www.catapultlabs.com/hubfs/Site/Footer/YouTube_full-color_icon.svg)](https://www.youtube.com/@catapultlabs)

© 2026 Catapult Labs. All Rights Reserved

[Terms](https://www.catapultlabs.com/legal?section=term_service)

[EULA](https://www.catapultlabs.com/legal?section=eula)

[Privacy Notice](https://www.catapultlabs.com/legal?section=global-privacy)

[SLA](https://www.catapultlabs.com/legal?section=service-level)

[Cookies Disclousure Policy](https://www.catapultlabs.com/legal?section=cookie-disclosure)

 Cookie Settings

```json
{
  "@context" : "https://schema.org",
  "@type" : "BlogPosting",
  "author" : {
    "@type" : "Person",
    "name" : "Luis Ortiz",
    "url" : "https://www.catapultlabs.com/blog/author/luis-ortiz"
  },
  "dateModified" : "2026-10-01T11:00:00.909Z",
  "datePublished" : "2026-10-01T11:00:00.000Z",
  "headline" : "Estimate Sprint Workload Accurately | Catapult Labs",
  "image" : [ "https://www.catapultlabs.com/hubfs/sprint-backlog-vs-scrum-poker-capacity-estimation.png" ],
  "mainEntityOfPage" : {
    "@id" : "https://www.catapultlabs.com/blog/estimate-sprint-workload-accurately",
    "@type" : "WebPage"
  },
  "publisher" : {
    "@type" : "Organization",
    "logo" : {
      "@type" : "ImageObject",
      "url" : "https://www.catapultlabs.com/hubfs/Site/Footer/Colors=True%2c%20Format=Horizontal%20(1).png"
    }
  }
}
```

```json
{
  "@context" : "https://schema.org",
  "@type" : "BlogPosting",
  "author" : {
    "@type" : "Person",
    "name" : "Luis Ortiz"
  },
  "dateModified" : "2026-10-01T11:00:00+0000",
  "datePublished" : "2026-10-01T11:00:00+0000",
  "description" : "Struggling with sprint overcommitment? Learn how to estimate sprint workload accurately and use Scrum Poker to surface your team&#39;s true capacity.",
  "headline" : "How to Estimate Sprint Workload Accurately (Without Over- or Under-Committing Your Team)",
  "image" : "https://www.catapultlabs.com/hubfs/sprint-backlog-vs-scrum-poker-capacity-estimation.png",
  "mainEntityOfPage" : {
    "@id" : "https://www.catapultlabs.com/blog/estimate-sprint-workload-accurately",
    "@type" : "WebPage"
  },
  "publisher" : {
    "@type" : "Organization",
    "logo" : {
      "@type" : "ImageObject",
      "url" : "https://www.catapultlabs.com/hubfs/Site/Clients/Colors=True%2c%20Format=Horizontal.svg"
    },
    "name" : "Catapult Labs"
  }
}
```

```json
{
  "@context" : "https://schema.org",
  "@type" : "FAQPage",
  "mainEntity" : [ {
    "@type" : "Question",
    "acceptedAnswer" : {
      "@type" : "Answer",
      "text" : "Because the failure point is usually the commitment, not the sizing. Teams estimate each story carefully, add up the points, and accept a total that looks reasonable without checking it against what they have finished in past sprints. Every individual estimate can be correct while the sprint total is still more work than the team has ever delivered in a single sprint."
    },
    "name" : "Why do sprint estimates go wrong even when story points are right?"
  }, {
    "@type" : "Question",
    "acceptedAnswer" : {
      "@type" : "Answer",
      "text" : "Estimating a story is a sizing judgment: how big one piece of work is relative to others the team has done. Estimating a sprint is a capacity judgment: how much of that sized work this specific team can absorb in the next sprint, given on-call rotations, PTO, and meetings. Sprint capacity comes from the team's own historical throughput and available hours, not a number set by leadership."
    },
    "name" : "What is the difference between estimating a story and estimating a sprint?"
  }, {
    "@type" : "Question",
    "acceptedAnswer" : {
      "@type" : "Answer",
      "text" : "Total the story points for everything you plan to pull in, then compare that total against your team's real historical capacity from the last four to six sprints, counting only finished work. Adjust for what is different this sprint, such as holidays, onboarding, or on-call load, and leave a buffer for unplanned work. If the total exceeds capacity, cut scope before the sprint starts."
    },
    "name" : "How do you estimate sprint workload accurately?"
  }, {
    "@type" : "Question",
    "acceptedAnswer" : {
      "@type" : "Answer",
      "text" : "Scrum Poker for Jira has every team member vote privately and at the same time, so estimates reflect what the whole team thinks instead of anchoring to the first or loudest voice. That makes the sprint total you compare against capacity more honest. It also keeps a sprint planning archive and sends final estimates back to Jira issues, so past sessions are easy to review at the next planning."
    },
    "name" : "How does Scrum Poker help a team estimate sprint capacity?"
  }, {
    "@type" : "Question",
    "acceptedAnswer" : {
      "@type" : "Answer",
      "text" : "Watch for four common traps: anchoring to your best sprint instead of your typical one, treating on-call time as free capacity, letting stretch goals quietly become committed scope, and ignoring the cost of context switching between unrelated stories. Plan against typical historical capacity, reduce the allocation for whoever is on call, keep stretch work explicitly optional, and group related stories where you can."
    },
    "name" : "How do you stop your team from overcommitting every sprint?"
  } ]
}
```
